    Industrial TMS for Indian manufacturing plants is not a highway map. This guide walks the plant control stack - gate, weigh, documents, delivery proof, pay - with inbound vs outbound differences, shortage and settlement visuals, and a demo checklist you can use next week.

    Industrial TMS for India hero: gate, weigh, documents, delivery proof, then pay - plant yard with ZAFTYS TMS | ZAFTYS Blog

    5

    Stages that matter

    Gate, weigh, documents, delivery proof, then money. Miss one and the rest argue.

    Inside

    Where time burns

    On busy plants, a lot of truck time is spent inside the boundary - not only on the highway.

    200 km

    e-Way day rule

    Normal cargo: about one day of validity per 200 km. ODC uses a tighter 20 km clock.

    49 / 55 t

    Weight ceilings

    MoRTH framing many plants plan around: rigid up to 49 t, tractor-trailer up to 55 t (check your axle layout).

    4 docs

    Before you pay

    Rate card, scale net, delivery proof, transporter bill. If they do not meet, do not clear blindly.

    Own / network

    Stay honest

    Owned trucks, contract trucks, and partner overflow should stay labeled through settlement.

    Chapter 01

    Start here

    If you run a busy Indian plant, you already know this: a glowing map pin does not run the yard. An industrial TMS has to own gate identity, locked weight, documents, delivery proof, and pay. Trucks wait at the gate. Weight gets typed. Papers get updated after the truck left. Delivery photos live in chat. Finance pays late because three files never agree.

    Industrial TMS (India plant): gate identity → locked weighbridge → LR / e-Way Bill → ePOD → freight pay. Not GPS-only — one trip identity through all five stages.

    This guide is for plant, logistics, and finance leads who want one trip story from boom open to payment. Time inside the plant is in hours. Weight is in tonnes under MoRTH rules. Money examples are in rupees and teaching-only until your contract says otherwise.

    Look at the five-stage picture first. Then who owns each stage. Then the donut. On many industrial days, a lot of truck time still burns inside the boundary - not on the highway. Bay and loading often eat the largest idle slice. That wait is real - and it belongs with production readiness and yard slots. This guide owns the control seams around it: gate, weigh, documents, delivery proof, and pay. Pair bay work with our plant detention and TAT post.

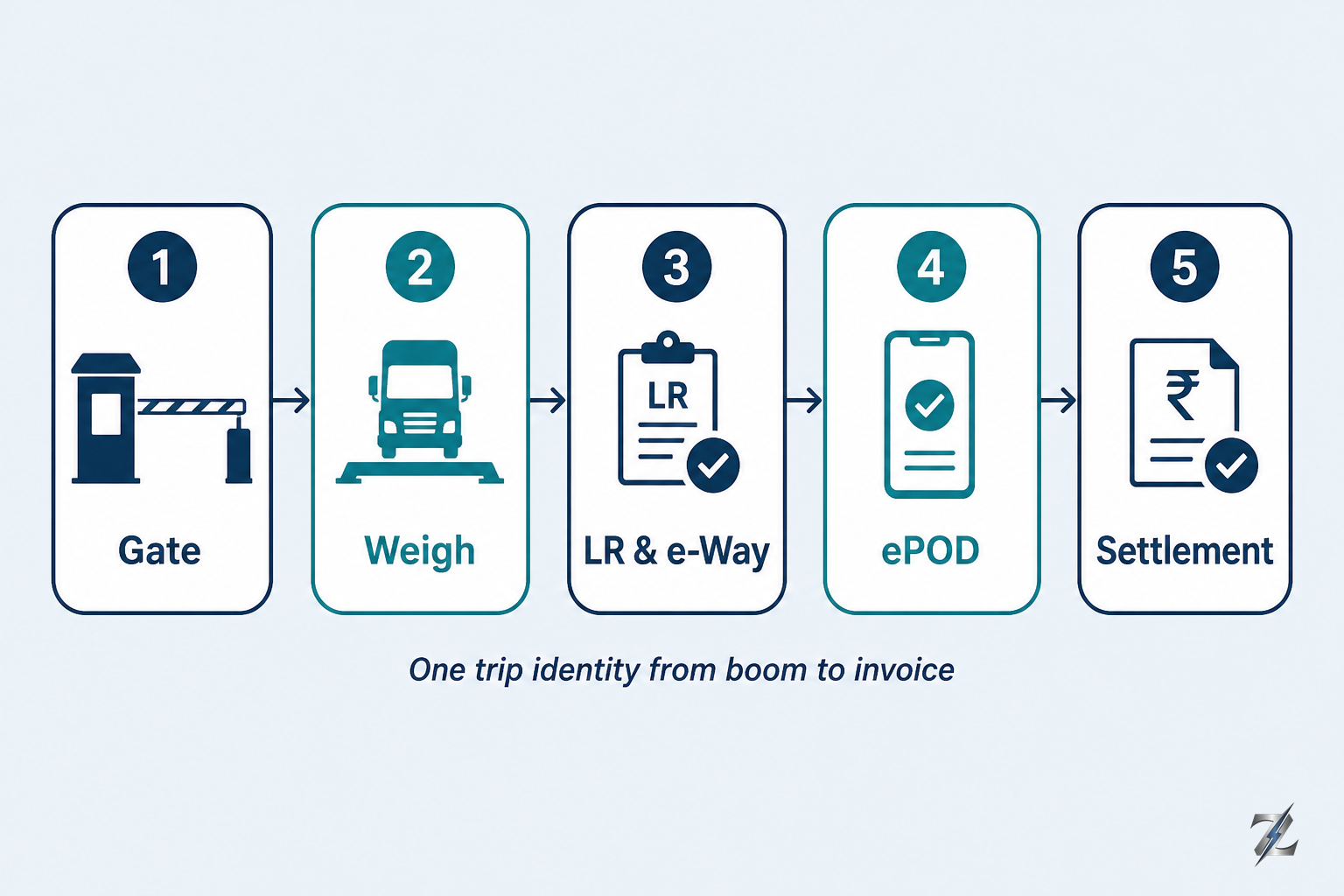

    The stack in one picture
    Five-stage industrial TMS control stack from gate to settlement

    Gate → weigh → documents → delivery proof → settlement. Bay and loading still burn time, but they sit with production / yard management - this guide owns the control seams around them.

    Who usually owns each stage

    01

    Gate

    Security + transporter desk. Identity, override log, queue.

    02

    Weigh

    Weighbridge / plant ops. Locked net, anti-cheat, overload block.

    03

    Documents

    Dispatch + tax. LR, e-Way Part B timing, night peak queue.

    04

    Delivery proof

    Dispatch + customer service. Link close, seals, shortage.

    05

    Settlement

    Finance + commercial. Fuel, detention, four-way match.

    Titles vary by plant. The point is one named owner per seam - not 'everyone and no one.'

    Where a busy plant day often goes (teaching picture)
    55%Inside the plant
    • Inside the plant · 55%
    • On the road · 30%
    • Unload / POD chase · 15%

    Not your exact plant. Useful for a workshop: a lot of truck time is still inside the yard.

    Chapter 02

    Why yards still leak money

    RFPs still fall in love with long-haul GPS. On steel, cement, chemical, and manufacturing desks, money often leaks earlier: gate, scale, documents, delivery proof, and accounts payable each keep their own truth.

    Picture 200 to 500 heavy trucks in a day. Security has a register. The weighbridge has a print. GST sits in a browser tab. POD is a WhatsApp photo. The transporter invoice is Excel. Queues stretch. Inventory argues. e-Way Bills lag. Bills sit for weeks.

    One industrial TMS keeps one trip identity through all five stages. Inbound raw material and outbound finished goods use the same spine - but the fights differ. Use both tables below. The idle-hour bars are workshop tools; swap in your last 90 days before anyone talks savings.

    Five places the story usually breaks

    Gate

    What you see

    Paper register, long queue

    What good looks like

    Truck ID tied to a real open order

    Weighbridge

    What you see

    Typed weight, arguments later

    What good looks like

    Scale feeds the system; edits are locked

    Documents

    What you see

    e-Way updated after the truck left

    What good looks like

    Vehicle details set before gate-out

    Delivery

    What you see

    POD photo lost in chat

    What good looks like

    Proof tied to the same trip, with shortage rules

    Payment

    What you see

    Three files, three truths

    What good looks like

    Four documents match - or a clear exception

    Walk one outbound lane with operations and finance. Ask who can still edit each record.

    Inbound raw material vs outbound finished goods

    Gate

    Inbound (raw / purchase)

    PO / indent check; priority when stock is low

    Outbound (finished goods)

    SO / packing readiness; avoid morning surge

    Weigh

    Inbound (raw / purchase)

    Tare first, then gross; purchase weight fights

    Outbound (finished goods)

    Gross then tare; overload risk before highway

    Documents

    Inbound (raw / purchase)

    Supplier / GST inbound rules

    Outbound (finished goods)

    LR + e-Way Part B before gate-out

    Proof

    Inbound (raw / purchase)

    Plant receives; quality / moisture often matter

    Outbound (finished goods)

    Customer receives; seals and shortage rules

    Pay

    Inbound (raw / purchase)

    Freight may sit with inbound logistics or vendor

    Outbound (finished goods)

    Four-way match before transporter payment

    Same five stages. Different fights. Do not copy one playbook onto the other without checking.

    Example idle hours on a rough plant day
    • Waiting at gate2.5 hours
    • Weigh / reposition fights1.2 hours
    • Bay wait + loading3 hours
    • Paper / e-Way at exit0.8 hours

    Teaching numbers. Bay wait is real - it belongs to production and yard slots, not to the five control stages below. Still measure it; fix it on a parallel track.

    Map vs control

    A map answers where the truck is. Control answers whether the plant may release it. That needs an open order at the gate, locked net weight, vehicle details on the e-Way Bill before exit (when required), proof a receiver will stand behind, and settlement finance can audit without a phone tree.

    If you still need a demo scorecard, use the TMS evaluation guide. For the short version of 'beyond GPS,' see TMS for heavy haul. This piece stays in the yard.

    Walk one outbound lane next week

    Take operations and finance together. At each break point ask: who just wrote the record, who can still edit it, and what happens when the next stage disagrees. If the answer is 'we call the transporter,' that stage is still manual - even if a camera exists.

    Do not average the five scores. Clean payment sitting on editable weight is still a broken scale. If your pain is mostly inbound purchase weight, walk an inbound lane the same way - do not assume outbound rules transfer.

    Chapter 03

    Gate: know the truck before the boom opens

    The gate is identity. When guards alone copy plates, check licences, and hunt open indents, you invent the first queue of the day - worse when inbound and outbound share one muddy lane at shift change.

    A solid stack tries more than one path: plate camera at crawl speed, plant RFID where you issue tags, and FASTag as a second chance when the plate is dirty. FASTag has been mandatory on commercial classes for toll since 2021. That helps at the plant gate. It does not mean every spot hire arrives tagged and alive.

    Spot trucks without plant tags still need a logged QR or WhatsApp pass after licence checks. Never a silent paper exception. Ask the vendor what happens when camera and tag both fail at 2 AM. If the answer is 'the guard writes it down,' you bought a camera, not control.

    Three ways in - and a backup

    01

    Number plate camera

    Reads the plate when the truck crawls in. Mud and broken fonts will still beat it sometimes.

    02

    FASTag / plant RFID

    Second chance when the plate is dirty. FASTag is mandatory on commercial classes for toll - useful at the gate too.

    03

    QR / WhatsApp pass

    For spot trucks and failed reads. Still logged. Never a silent paper exception.

    04

    Order check

    No open indent? Boom stays down. Override only with a name and a reason.

    You do not need every gadget on day one. You do need a logged fallback when cameras fail at 2 AM.

    What to ask in the demo

    Show me failure

    Ask what happens when the plate cannot be read and the tag is dead. If the answer is 'guard writes it down,' you bought a camera, not control.

    Show me the log

    Every override should leave a trail finance and security can replay later.

    ANPR and FASTag plant gate identity

    Plate camera at crawl speed plus FASTag as failover, with a logged QR or WhatsApp pass when both fail - never a silent paper exception. Where ULIP or similar authorised links are live, you can check driver and vehicle fitness signals against government masters. That needs onboarding - it is not a free public search.

    Failed checks keep the boom down, alert the desk, and send the truck to staging. Managers can still override for real exceptions - with a log security and finance can replay later.

    One lane, two directions

    Plants that reverse inbound and outbound on one approach without sensors invent their own accidents. Directional loops, separate camera profiles, and priority for critical inbound raw materials stop two queues fighting for the same boom.

    Adding one more guard rarely beats a second identity lane or honest slot windows. Your TMS should show queue depth and wait by hour - the same numbers you will freeze when you score maturity.

    Identity before the boom

    Walk your gate exceptions with the desk

    Tell us daily truck volume, how many spot hires you take, and whether inbound and outbound share one lane. We map plate cameras, FASTag failover, and order-linked passes without pretending every truck arrives tagged.

    Chapter 04

    Weighbridge: the plant cash register

    Every accepted kilogram feeds inventory, cost of goods, and freight pay. Typed weights in a browser invite ghost tare slips and month-end inventory theatre.

    Pull weight from the indicator. Accept only a stable reading. Block capture when the truck is half on the deck. On outbound, force gross then tare. On inbound purchase weighment, tare first then gross - and keep the same anti-cheat rules. Kill old light slips when the truck leaves. Only then compare recorded weight to the legal class for that axle layout before anyone prints a clean gate-out.

    The bar chart shows planning ceilings many plants use. Mid axle configs and full tables live in our axle load and GVW guide. Confirm OEM ratings and air suspension before you treat any tonne figure as dispatch law. Blocking overload inside the plant is cheaper than a highway stop.

    Weight ceilings many plants plan with (tonnes)
    • 2-axle rigid18.5 t
    • 3-axle rigid28.5 t
    • Rigid ceiling49 t
    • Tractor-trailer ceiling55 t

    MoRTH 2018 framing for common classes. Mid configs (4-axle / 5-axle rigid and more) live in the axle load guide - encode by layout, not one magic number.

    Simple anti-cheat checks

    01

    Truck fully on the deck

    Beams or sensors catch half-on wheels before you accept a weight.

    02

    Stable reading only

    Ignore bouncing numbers. Wait for a stable signal from the indicator.

    03

    Tare has an expiry

    Old light tare slips should die after a set window or when the truck leaves.

    04

    Over legal weight?

    Block gate-out and offload inside the plant. Cheaper than a highway stop.

    Weighbridge lock in a TMS

    A weighbridge lock accepts the indicator feed, blocks typed weight, and fails closed at gate-out when the net is illegal - encode MoRTH axle and GVW ceilings here (axle load and GVW guide). Keep Legal Metrology stamps and recalibration dates in the master data. A clever workflow on an unstamped deck still fails audit.

    Common tricks: wheels off the platform, helpers on the deck during tare, recycled light slips, bumper transfer between trucks. Beams, stability windows, camera snaps, and tare expiry beat slogans. Kilogram thresholds are your plant policy - not a national statute.

    MoRTH ceilings and overload risk

    S.O. 3467(E) is the axle and GVW framing many yards teach as about 49 tonnes rigid and 55 tonnes tractor-trailer. Air suspension can add where the notification allows - confirm layout before coding a bonus.

    Section 194 frames overload penalties. Many yards also set a small plant tolerance before hard lock. Encode that as policy; do not market it as a legal +5% right.

    Locked weight before the highway

    See how scale lock sits inside ZAFTYS TMS

    Bring a typed-weight dispute and your axle mix. We show how locked nets, overload blocks, and gate-out rules land on the same trip record - before anyone celebrates a map.

    Chapter 05

    Documents: LR and e-Way Bill

    Once net weight is locked, bind the carriage paper (LR / bilty) and the GST e-Way Bill when movement needs one. Tax invoice duties sit under Section 31 and Rule 46. E-invoicing under Rule 48 is a different track for notified businesses - do not confuse it with bilty generation.

    Rule 138 is the e-Way engine: Part A for consignment details, Part B for the vehicle. Normal cargo uses about 200 km per day of validity. Oversize work uses about 20 km per day. Not every truck movement needs an e-Way Bill - value thresholds, some goods, and certain short or exempt cases skip it. Ask tax, then encode skip rules so the TMS does not invent fake bills.

    If your dispatch leads cannot explain Part A vs Part B in one minute, automating documents only speeds up confusion. Use the validity picture with them.

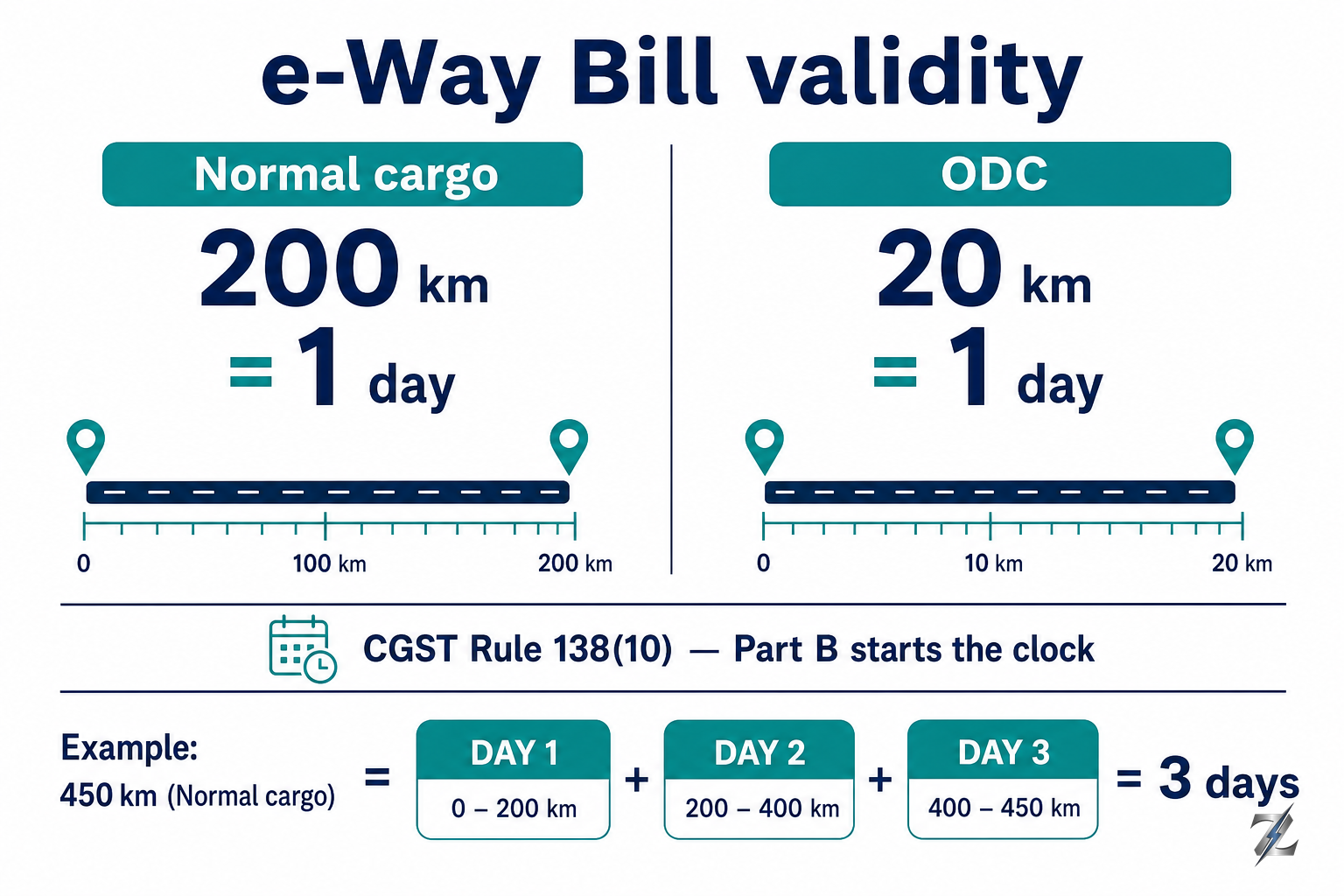

    How long an e-Way Bill lasts
    Infographic of e-Way Bill validity: 200 km per day for normal cargo, 20 km for ODC

    CGST Rule 138(10). Normal cargo uses 200 km per day. Oversize work uses 20 km per day. The vehicle details (Part B) are what start the useful clock. Not every movement needs an e-Way Bill - confirm threshold and exemptions with tax.

    A sane document order
    1. 01

      Weight is locked

      Net comes from the scale, not a typed field someone can 'fix.'

    2. 02

      LR / bilty

      Carriage document for the transporter - tied to that net.

    3. 03

      e-Way Part A

      Consignment details when an e-Way Bill is required. Waiting for a truck is fine.

    4. 04

      e-Way Part B

      Put the real vehicle number before the truck leaves. Then the distance clock makes sense.

    Multi-drop without inventing a second inventory
    1. 01

      Parent trip

      One truck, one locked scale net for the whole load.

    2. 02

      Child LRs

      Separate carriage lines per consignee / drop.

    3. 03

      Child e-Way Bills

      Separate bills when required - vehicle number stays consistent.

    4. 04

      Weight check

      Child weights must sum to parent net. If not, stop and fix.

    One registration, one certified net, child documents that still add up.

    When e-Way does not apply

    Ask tax, then encode the rule

    Value thresholds, certain goods, and some short / exempt movements do not need an e-Way Bill. Your TMS should skip generation cleanly - not invent a fake bill to 'complete the flow.'

    Night peak without lockouts

    Do not hammer the GST portal in a tight loop at 23:00. Queue vehicle updates, retry calmly when the portal is busy, and keep a human path for stuck bills.

    e-Way Bill Part B before gate-out

    Do not start movement on Part A alone when an e-Way Bill is required. Put the real vehicle number before gate-out so the distance clock makes sense. If yard wait burns validity, alert early. Software may extend only inside the legal window (within about eight hours of expiry) and only for allowed reasons. Unlimited auto-extend is a compliance risk, not a feature.

    Multi-drop work needs child LRs and separate e-Way Bills per consignee while one registration moves the set. Child weights must still sum to the one certified net. If they do not, you invented a second inventory. Use the multi-drop flow below with dispatch before you automate splits.

    Night peak without portal lockouts

    Cement and steel night peaks are when 'integrated GST' either works or fails. Queue vehicle updates. Retry calmly when the portal is busy. Keep a human path for stuck bills. Do not hammer the portal in a tight loop.

    Confirm current GSTN behaviour at go-live. Portals change faster than blog posts.

    Chapter 06

    Delivery proof without another app war

    Delivery is not done when the truck leaves your gate. Proof has to survive shortage, seal, and receiver disputes. Forcing every market driver to install another app usually fails. A WhatsApp or SMS link with a location check closes more trips.

    Simple flow: truck near site, open the link, capture signed paper and seal photos, receiver confirms, compare factory net to customer weight when the commodity needs it. Over contract tolerance becomes a debit on the same trip - not a quiet deduction in month-end.

    Encode shortage and seal rules once with commodity managers. The shortage picture below is a teaching example - swap in your tolerance and rate, then stop renegotiating in chat. Spot-heavy lanes should lead with a link; dedicated fleets can still use an app.

    A flow drivers will actually finish
    1. 01

      Near the site

      System sees the truck close to the unloading point.

    2. 02

      Open a link

      WhatsApp or SMS - no forced heavy app for one plant.

    3. 03

      Capture proof

      Signed paper, seal photos, optional customer weight.

    4. 04

      Receiver confirms

      OTP or clear acceptance closes the trip.

    5. 05

      Shortage?

      Over the contract tolerance → debit on the same trip, not a side chat.

    Shortage check (teaching example)

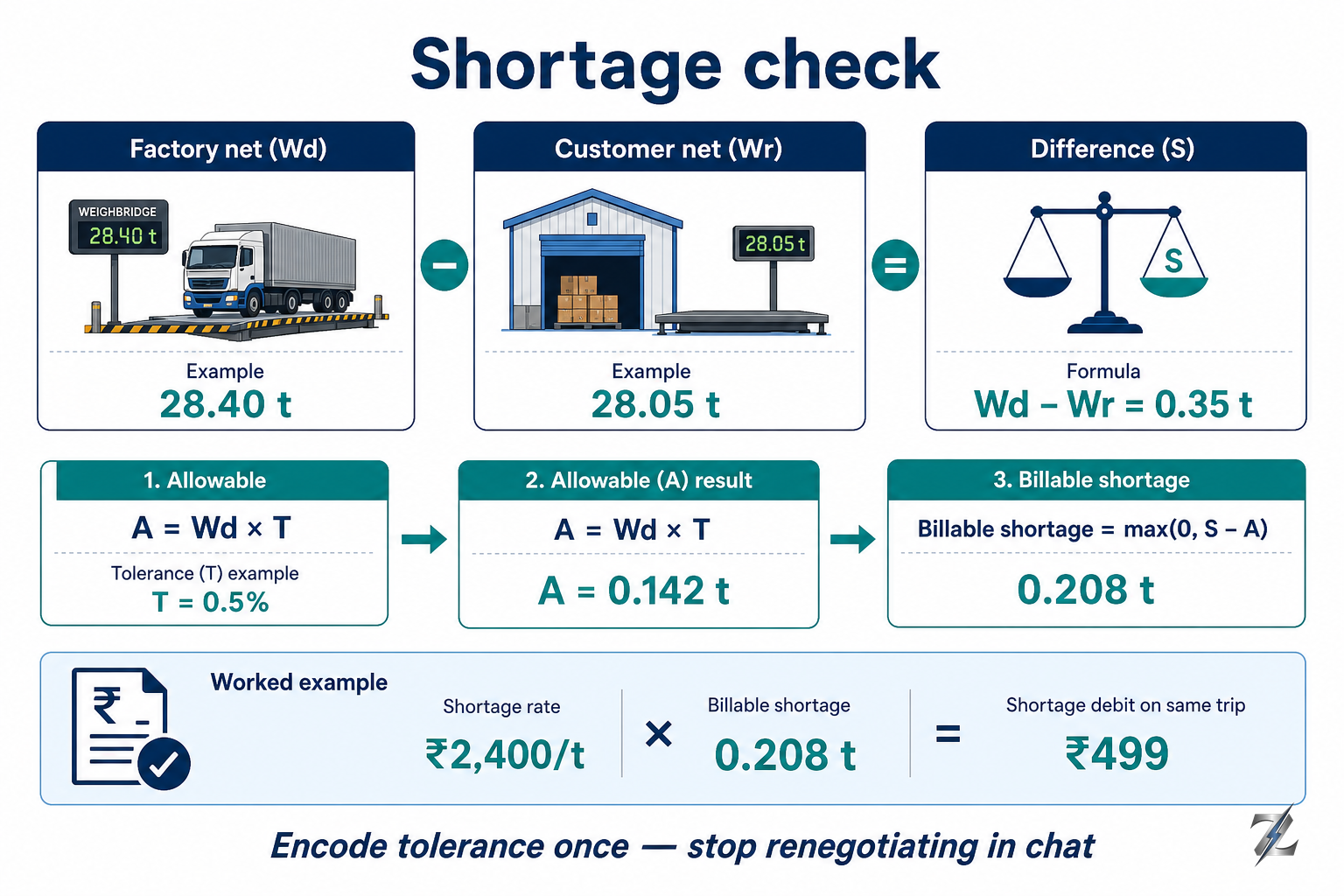

    Infographic of factory net vs customer net, tolerance, and billable shortage debit

    Swap in your commodity tolerance and rate. Encode once with commodity managers - stop renegotiating in chat.

    App vs link

    Spot-heavy lanes

    Many drivers will not install another app for one plant. Lead with WhatsApp or SMS session links.

    Dedicated fleets

    A proper driver app can still win when the same fleet lives inside your programme every day.

    Shortage and seals

    Bulk cargo moves moisture and scale difference. Contracts often allow a small percentage before penalty. Write factory net, customer net, tolerance, and billable shortage into the system. Never mix bags and tonnes silently.

    Seal number mismatch against the LR should hold freight clearance. That one rule prevents many 'delivered but disputed' fights. More billing detail sits in the ePOD and e-Way Bill guide.

    Close the trip cleanly

    See how delivery proof feeds billing

    Bring one shortage dispute and one paper POD pack. We show how a simple link and receiver confirmation land on the same trip finance will match.

    Chapter 07

    Settlement: fuel, detention, four-way freight matching

    Four-way freight matching means rate card + certified scale net + approved ePOD (minus claims) + transporter bill agree before you pay. Settlement turns timestamps and weights into money. Almost every industrial rate card has diesel escalation and plant detention. The two pictures below show the shape - swap in your contract numbers.

    Before you pay: rate card, scale net, approved delivery proof (minus claims), transporter bill. The match table shows what each document must prove and who owns a mismatch. Small variance under finance tolerance can clear with an audit note.

    On SAP landscapes, prefer S/4HANA Transportation Management for new builds over legacy LE-TRA habits. The short object map below is the shape finance and IT should agree on - order, trip with locked weight, goods or service confirm, then invoice match. Confirm transaction names with your SAP partner.

    Diesel escalation (contract math)

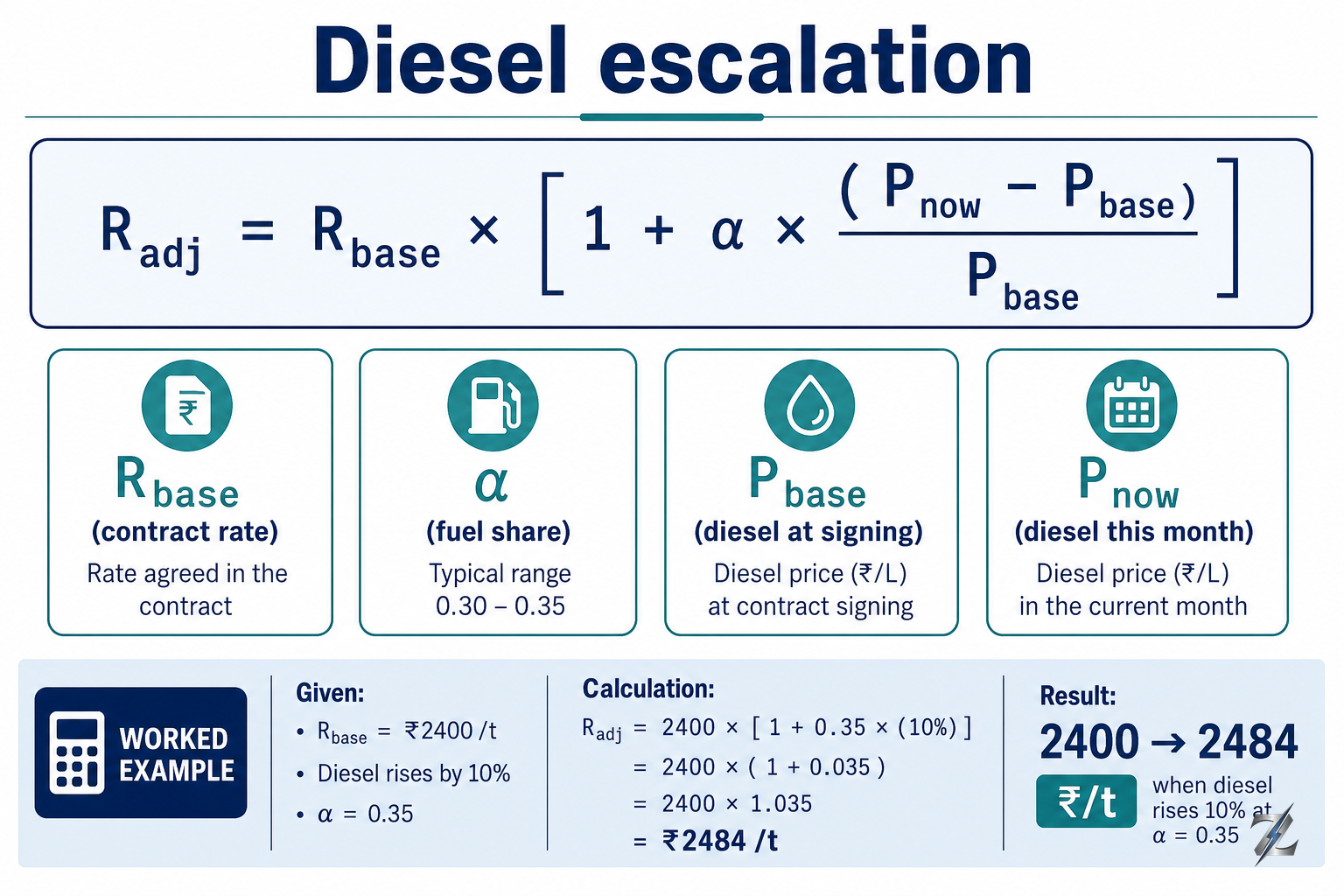

    Infographic of diesel freight escalation formula with worked rupee example

    α is usually negotiated around 0.30–0.35. Lock the base diesel city and the formula in writing. Rupee example is teaching only.

    Plant detention clock

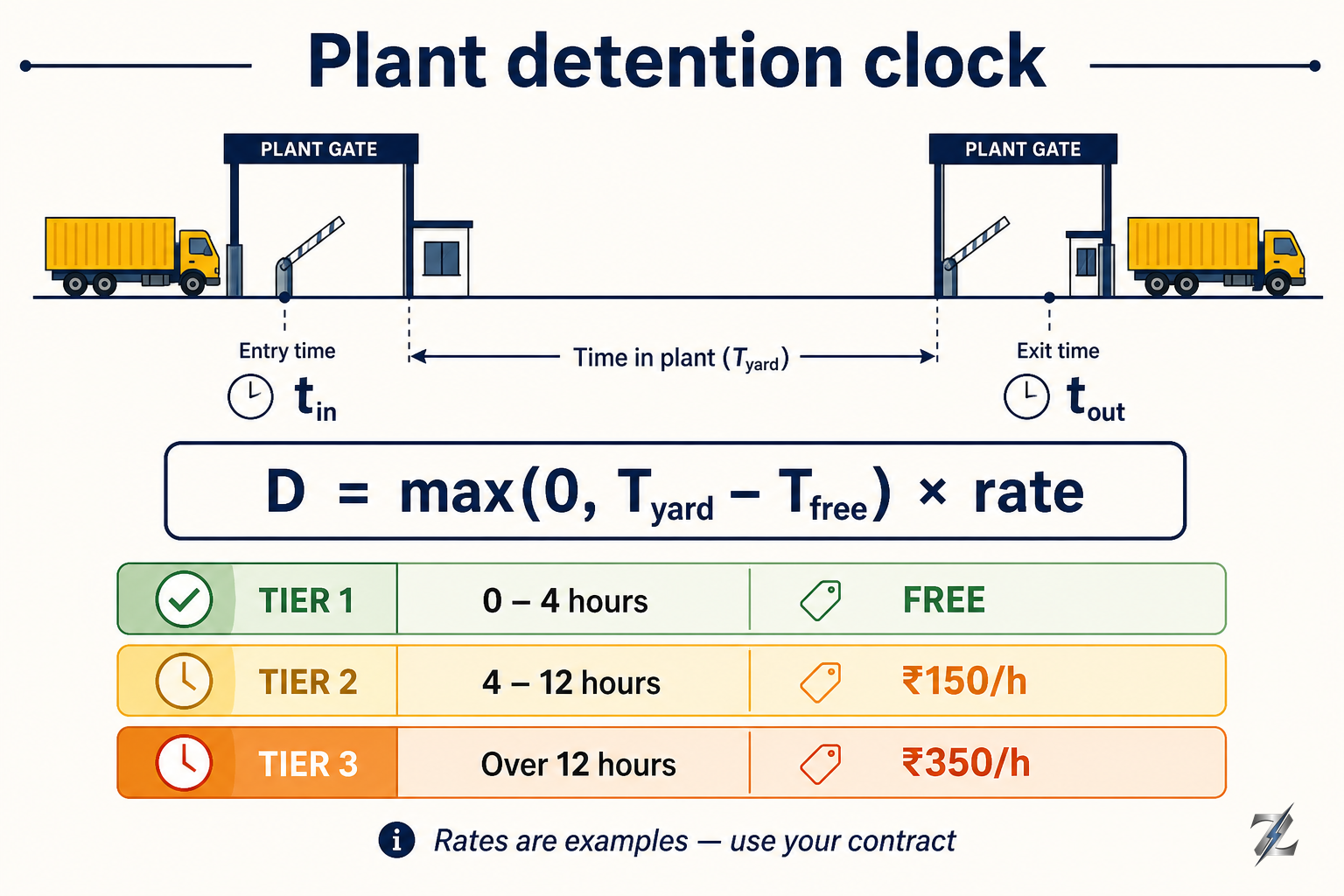

    Infographic of plant detention free time and hourly tiers

    Use gate-in and gate-out from the same identity system. The ₹/hour bands are examples - swap in your rate card.

    Four-way match - and what to do when it fails

    Rate card

    Must show

    Lane, fuel α, detention tiers

    If it disagrees

    Hold line → procurement / commercial

    Scale net

    Must show

    Certified gross / tare trail

    If it disagrees

    Hold pay → plant weigh + transporter desk

    Delivery proof

    Must show

    Closed POD, seals, shortage debit

    If it disagrees

    Hold pay → dispatch / customer service

    Transporter bill

    Must show

    Same trip, same maths

    If it disagrees

    Clear rest after debit / fix → finance

    All four must agree before you pay. Named exception + owner beats a blocked payment run nobody owns.

    ERP object map (SAP-shaped, keep labels honest)
    1. 01

      Order / delivery

      Sales or purchase order and delivery / shipment object that the gate can check.

    2. 02

      Freight / trip

      TMS trip or freight order carrying gate stamps, locked net, and documents.

    3. 03

      Goods / service confirm

      Plant goods movement or service confirmation that finance will trust.

    4. 04

      Invoice match

      Four-way clear (or coded exception) before payment run - MIRO-style on SAP.

    Names vary by landscape. The point is one trip identity through weight, service entry, and invoice match - not a slide full of transaction codes.

    Own fleet vs labeled overflow

    ZAFTYS runs owned heavy vehicles, contract programmes, and labeled partner overflow. The five stages do not change. Settlement must still show which capacity moved the trip so finance never books overflow as company fleet.

    Marketplace listing and search on TranZfort stay free; a broker fee applies on booked loads. For one desk on the whole stack, start at industrial freight or contact.

    Fuel and detention without folklore

    Diesel share of road cost is often negotiated around 0.30 to 0.35 - lock the number, the base city, and the index in writing. Detention free time and hourly rates must use the same gate clocks that opened the boom. 'We waited twelve hours' is not an input.

    Post fuel surcharge and detention as separate lines when the contract separates them. Burying both inside base freight is how disputes come back after you thought matching was done.

    Chapter 08

    How mature is your yard?

    Skip vanity scores out of 100. Place gate, weigh, documents, delivery proof, and payment in Manual, Half-digital, or Under control using the last 90 days of proof. A live map with editable weights is still Manual integrity.

    Rank the weakest gap that blocks the next step. Most Indian industrial shippers sit in Half-digital: cameras and portals exist, but one trip identity does not survive into payment.

    Manual · Half-digital · Under control
    Tap a score in the room. 1 weak · 5 proven live.Skip the line = 0 (tap again to clear). Do not mark phase two.

    Paper book

    Weight ·Lines Gate-Gate

    1. Gate

      Camera, no order link

    Typed slip

    Weight ·Lines Weigh-Weigh

    1. Weigh

      Print, still editable

    Portal after exit

    Weight ·Lines Documents-Documents

    1. Documents

      Vehicle details late

    Photo in chat

    Weight ·Lines Delivery-Delivery

    1. Delivery

      App nobody opens

    Excel fight

    Weight ·Lines Payment-Payment

    1. Payment

      Three-way leaks

    Use the last 90 days of proof. Do not average five scores into one happy label.

    How to run the review

    Bring plant, dispatch, procurement, and finance into one room. For each area demand evidence: gate wait chart, scale near-miss log, sample vehicle-update timing, days to delivery proof, exception age in accounts payable. No pack means Half-digital at best.

    Do not average the five areas into one happy label. Clean payment on paper LRs is still Manual cash. Clean maps with no weight lock are still Manual payload risk.

    When the gap is control, not trucks

    Score Manual vs Under control on your yard

    Bring 90 days of gate waits, scale fights, e-Way misses, and invoice cycle days. We rank which seam blocks the next step in ZAFTYS TMS.

    Chapter 09

    Build in the right order

    Six-week posters stall when the weighbridge vendor, security, and transporters disagree. Keep the order fixed: measure first, fix gate and scale, then documents, then delivery proof and money.

    Pilot one plant corridor with real truck volume. Freeze your denominators - the same units for 90 days: gate wait hours, weight-fight counts, document-miss rate, days to POD, days to pay. Prove you clear exceptions. Then widen. National rollouts of half-wired stacks only multiply chat - and the cost of untangling nets you already paid against.

    Order of work that usually sticks
    1. 1

      Measure first

      Gate waits, weight fights, document misses, days to POD, days to pay.

    2. 2

      Fix gate + scale

      Identity and locked weight before you celebrate a live map.

    3. 3

      Documents

      LR and e-Way discipline, including night peak queues.

    4. 4

      POD then money

      Close delivery proof, then fuel, detention, and four-way match.

    Calendars slip. This order should not.

    Freeze these denominators before anyone claims savings

    01

    Gate wait (hours)

    Median and 90th percentile from identity clear to leave staging / enter bay.

    02

    Weight fights (count)

    Typed overrides, reposition reweighs, overload blocks per 100 trips.

    03

    Document misses (%)

    Trips that left without vehicle details set when e-Way was required.

    04

    Days to POD / pay

    Gate-out to closed proof; closed proof to cleared transporter bill.

    Same units for 90 days. No mixing median with best-day hero stories.

    Keep reading (full paths on this site)

    Buying a TMS?

    Score demos with /blog/tms-evaluation-guide-indian-manufacturers before you buy hardware theatre.

    Axle and GVW

    Hardcode weight rules only after /blog/india-axle-load-gvw-limits-heavy-freight.

    Yard time and billing

    Neighbour posts: /blog/plant-detention-tat-yard-gate-india and /blog/epod-fastag-eway-bill-billing-india.

    Why calendar-first programs stall

    Teams buy a demo, schedule six weeks, and skip baseline. Or finance demands automated invoices before gate timestamps exist. Or sales promises detention savings while free-time clocks are still verbal.

    Dependency-led builds feel slower in month one and faster by month three because rework drops. Use week bands for planning after IT and plant security say yes - not as a go-live date printed without hardware lead times.

    Chapter 10

    What to do next

    When manufacturers close the five stages, yard waits, shortage fights, document misses, and invoice cycle time usually move in the right direction. Treat any percentage claim as a planning band until your 90-day baseline exists - never as a guaranteed return, and never as 'zero fraud / perfect match' marketing.

    Take the ten demo questions below into the next vendor meeting. Keep reading plant detention and TAT, axle load and GVW, and ePOD billing. Operator login for ZAFTYS TMS is at app.zaftys.com.

    Ten questions for the next vendor demo
    1. 01

      Gate fail

      Show plate fail + dead tag. What happens at 2 AM?

    2. 02

      Override log

      Show name, reason, and replay for security / finance.

    3. 03

      Half-on deck

      Show weigh capture blocked when the truck is not fully on the scale.

    4. 04

      Tare expiry

      Show old light slips die after gate-out or policy window.

    5. 05

      Part B timing

      Show vehicle details set before gate-out when e-Way is required.

    6. 06

      Portal busy

      Show calm retry - not a tight loop - when GST is slow at night.

    7. 07

      Link POD

      Show WhatsApp/SMS close without forcing an app install.

    8. 08

      Shortage debit

      Show tolerance math and debit on the same trip identity.

    9. 09

      Four-way mismatch

      Show a named exception with an owner, not a silent short-pay.

    10. 10

      Capacity label

      Show own fleet vs labeled overflow on the settlement line.

    If they cannot answer live, park the glossy map slide.

    Appendix

    Frequently asked questions

    What is an industrial TMS for Indian plants?

    An industrial TMS for Indian manufacturing plants runs the control stack from gate identity through locked weighbridge, LR and e-Way Bill, delivery proof (ePOD), and freight settlement - not only a GPS pin on the highway. This post is that ops walk. For buying scorecards, see the TMS evaluation guide.

    How is this different from a TMS evaluation checklist?

    The TMS evaluation guide helps you score demos. This piece is what must work after you buy: gate identity, locked weight, e-Way Bill clocks, delivery proof, and invoice match.

    Is FASTag mandatory for plant gates?

    FASTag is mandatory for M and N class vehicles on national electronic toll collection from 1 January 2021. Plants can use it as a second identity signal. Spot trucks still need a logged fallback when the tag fails.

    What weight ceilings should a TMS encode?

    Many plants plan around MoRTH framing of about 49 tonnes for rigid vehicles and 55 tonnes for tractor-trailers. Encode by axle layout, not one magic number. See our axle load and GVW guide.

    What is the e-Way Bill distance rule?

    Under CGST Rule 138(10), normal cargo gets about one day of validity per 200 km (or part). Oversize cargo uses about one day per 20 km. The useful clock follows the vehicle details (Part B) - confirm current portal behaviour at go-live.

    Can software auto-extend every e-Way Bill?

    No. Extensions are for exceptional cases and only inside the legal window (within about eight hours of expiry). Build early alerts and human review. Do not sell unlimited auto-extend.

    Why WhatsApp delivery proof instead of a driver app?

    Many drivers will not install another app for one plant. A WhatsApp or SMS link with a location check and receiver confirmation usually closes more trips. Dedicated fleets can still use a proper app.

    What is four-way freight matching?

    Before you pay: rate card (including fuel clauses), certified scale net, approved delivery proof minus shortage or damage, and the transporter bill. Mismatches become named exceptions - not silent short-pay fights in chat.

    Should new plants still build on SAP LE-TRA?

    For new TMS-to-ERP work, prefer SAP S/4HANA Transportation Management over legacy LE-TRA. Confirm support dates with your SAP partner.

    How do own fleet and network capacity show up?

    The five stages stay the same. Settlement must still label the trip: company-owned, contract-reserved, or partner overflow. Never present labeled overflow as owned fleet.

    Does the same stack apply to inbound raw material?

    Yes - gate, weigh, documents, proof, pay - but the fights differ. Inbound usually tare-then-gross and purchase-weight disputes. Outbound usually gross-then-tare and overload risk before the highway. Walk both lanes separately.

    Does every movement need an e-Way Bill?

    No. Value thresholds, some goods, and certain short or exempt cases skip it. Ask tax, then encode skip rules so the TMS does not invent fake bills to complete a workflow.

    How should shortage be calculated?

    Compare factory net to customer net, apply contract tolerance, then bill only the excess on the same trip. Encode the tolerance and rate once - do not renegotiate in chat. Teaching example is in the shortage exhibit in this post.

    Where do ULIP and Vahan fit?

    ULIP can expose vehicle and licence data to onboarded applications. Useful at the gate when your agreements are live - not a free public lookup.

    What is a weighbridge lock in a TMS?

    A weighbridge lock accepts weight from the indicator, blocks typed overrides, and fails closed at gate-out when the net breaks axle or GVW rules. Encode MoRTH ceilings by axle layout - see the axle load and GVW guide.

    When should e-Way Bill Part B be updated?

    Before the truck leaves the plant when an e-Way Bill is required. Part A is consignment detail; Part B is the vehicle. Starting the trip on Part A alone makes the distance clock meaningless and creates portal fights later.

    What is four-way freight matching in industrial TMS?

    Before you pay: rate card (including fuel clauses), certified scale net, approved ePOD minus shortage or damage, and the transporter bill. Mismatches become named exceptions - not silent short-pay fights in chat.

    What is ANPR at a plant gate?

    Automatic Number Plate Recognition reads the plate at crawl speed so the gate can match an open order. Pair it with FASTag failover and a logged QR or WhatsApp pass when cameras and tags both fail - never a silent paper exception.

    Sources

    References and data sources

    Public sources below are for orientation. They are not ZAFTYS audited financials. Read the originals before a number goes into a board pack.

    1. [1]MoRTH S.O. 3467(E) (2018) on axle weight and GVW / GCW ceilings - confirm current gazette text.
    2. [2]Motor Vehicles Act Section 194 on overload penalties - confirm current notified amounts with counsel.
    3. [3]CGST Rule 138 / 138(10) on e-Way Bills: Part A / Part B, 200 km and 20 km slabs, extension window near expiry.
    4. [4]CGST Act Section 31 and Rule 46 on tax invoices. Rule 48 is e-invoice for notified businesses - a different track.
    5. [5]NETC / FASTag: mandatory for M and N class vehicles from 1 January 2021 (MoRTH / IHMCL).
    6. [6]ULIP / DPIIT for authorised vehicle and driver data access when your application is onboarded.
    7. [7]Legal Metrology / OIML R76 Class III for industrial weighbridges - keep stamps and recalibration dates.
    8. [8]SAP LE-TRA toward S/4HANA Transportation Management - confirm support dates with your SAP partner.
    9. [9]ZAFTYS plant and corridor work, 2024–2026 - directional, not a national survey.

    Deep research next step

    Need trucks first?

    Most readers need corridor capacity, not a new login. Share your gateway, inland plant, container mix, and weekly volume on the contact form. We place trailers as your transport partner. Need software or a load board afterward? Use the links below.

    Or return to the blog index.
